Can the calculator replace a civil or structural design?
No. It produces a preliminary module arrangement and material allowances. Final drainage, structural, geotechnical and construction design must be completed for the project.
What cover and tank depth does Rev 15 screen?
Rev 15 uses 600 mm for VPP60 and RPP60 and 700 mm for RPP45 in open-space/light-traffic applications. The preliminary car-park row is 700 mm for VPP60 and RPP60 and 800 mm for RPP45, but the actual vehicle, wheel and axle loads, pavement and repetition still require project checks. The W80 semi-trailer/heavy-vehicle row uses at least 800 mm with VPP60 or controlled RPP60; RPP45 is not recommended. The standard guide geometry remains capped at five aligned 500 mm layers, or 2.5 m, subject to project-specific verification.
Why is the minimum project size approximately 100 m³?
Kontain manufactures against confirmed projects rather than holding finished tank stock. Tanks from approximately 100 m³ can be quoted, but smaller or part-container shipments usually carry higher port handling and freight cost per cubic metre. Final minimums depend on the selected product, component pack and delivery programme.
Does 60 t/m² mean ULTRA is automatically suitable beneath a road?
No. That is a published short-term compression class, not an allowable trafficked-system capacity. Cover, pavement, backfill, creep and load distribution must be checked.
Do the recycled R60 and R45 variants share the virgin V60 test result?
No. The current Intertek compression and interim creep reports through day 91 apply only to the tested virgin V60 specimens and reported configurations. Equivalent variant-specific evidence has not yet been supplied for R60 or R45.
Can Kontain supply the liner with pipe penetrations already formed?
Yes, subject to confirmed tank dimensions, pipe material, diameter, orientation and invert levels. Prefabrication reduces uncontrolled field detailing but does not remove the need for installation QA.

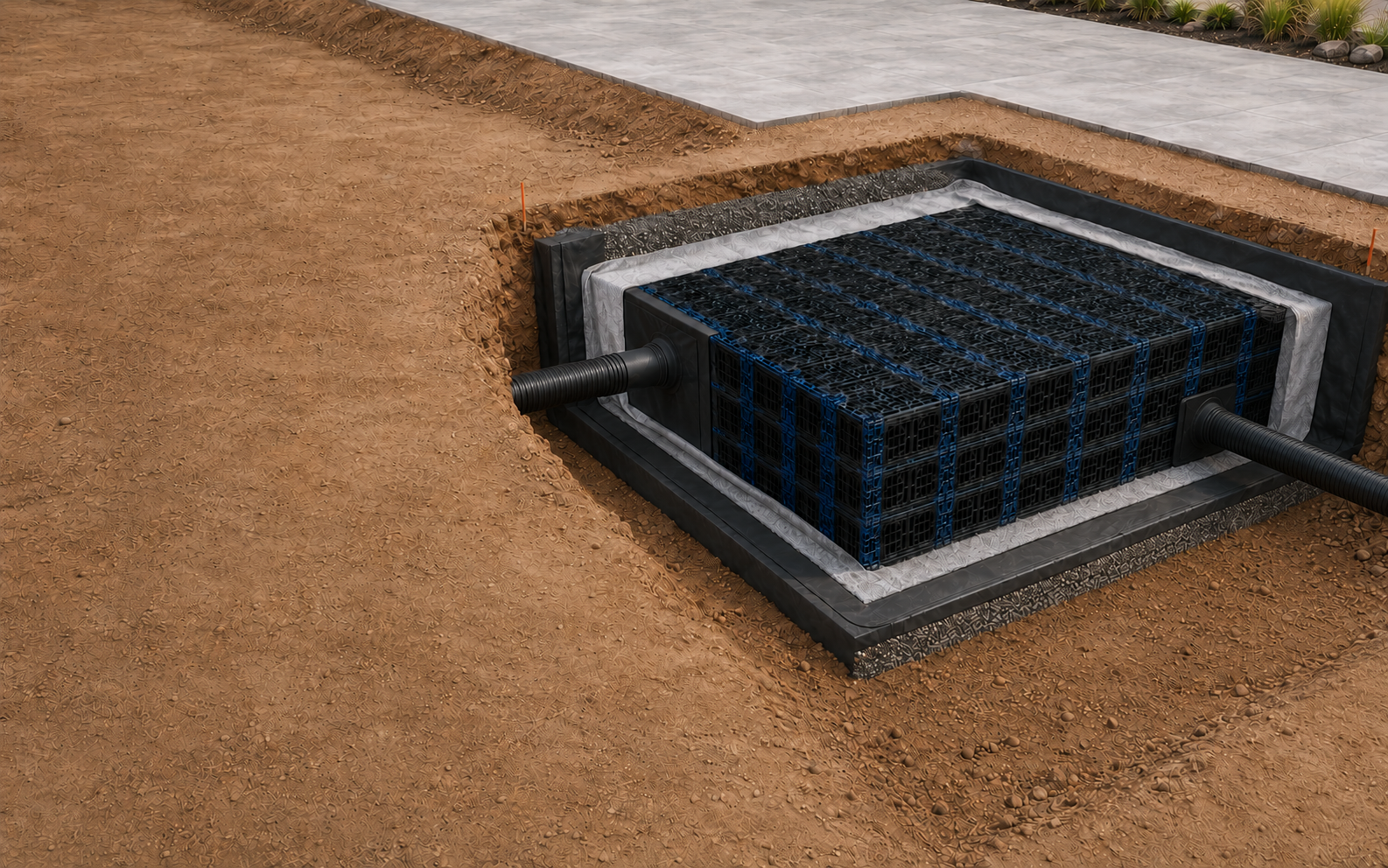

How are large pipes connected without cutting M2025 load columns?
Complete modules are displaced to form an accessible pit inside the tank and liner footprint. Every side panel facing the pit opening is omitted, but the structural module columns and rails remain intact. The pipe, pit, liner boot and wall seal are independently detailed and supported.
Can a pressure-washing system be included?
Yes, as an optional project-designed maintenance system. The accessible connection and controls sit in the service pit and connect through its open face to a DN50 header installed at tank-floor level inside the module field. The header feeds hydraulically zoned DN25 perforated laterals toward a downstream vacuum pit. Pump duty, pressure, perforations, spacing, restraint and commissioning must be designed for the project.
Is installation guidance available for tendering and site planning?
Yes. The M2025 installation guide covers responsibilities, enclosure options, excavation controls, assembly, liner and geotextile placement, pipework, backfill, commissioning and QA hold points. Approved project documentation still governs construction.
Will the calculator issue an instant binding price?
No. It creates the project configuration and quote basis. Kontain checks current supply and logistics costs, confirms the technical inputs with you by phone and then issues the formal quote.
